Projects / Aro Valley Wastewater Renewals

Aro Valley Wastewater Renewals

On behalf of Wellington City Council, Wellington Water is renewing several sections of wastewater pipe in the Aro Valley area.
Overview
Background
All Updates

We’re renewing over 1km of wastewater pipes in Aro Valley to reduce leaks and overflows, protect our natural environment and strengthen the resilience of the network.

Contact:

If you have any questions about this work, please contact:

Wellington Water, 04 912 4400

Latest Updates

22 June 2026 Night works on Aro Street starting early July

17 June 2026 Indicative schedule of works

12 June 2026 Works beginning 15 June on Holloway Road

Wellington Water, on behalf of Wellington City Council, is re-lining a section of the wastewater pipe which serves households on Holloway Road.

We’re renewing over 1km of wastewater pipes in Aro Valley to reduce leaks and overflows, protect our natural environment and strengthen the resilience of the network.

 CCTV investigations by Wellington Water in 2016/2017 identified sections of the wastewater network in Aro Valley were in need of renewal. Many of these pipes are made of earthenware and at the end of their working lifespen, with cracks, breaks and root intrusion identified in several areas.

These issues create a risk of wastewater leakage into the surrounding soil and stormwater network, with potential impacts on public health.

The works involve a mix of excavating and installing new pipes, and re-lining existing pipes to increase their durability and lifespan.

Work will be undertaken at:

  • Adams Terrace
  • Aro Street
  • Fairlie Terrace
  • Holloway Road
  • Landcross Street
  • Maarama Crescent

All Updates

22 June 2026 Night works on Aro Street starting early July

As part of our programme to repair and upgrade ageing wastewater pipes in Aro Valley, our contractors Brian Perry Civil will be doing night works from 162 to 206 Aro Street, beginning in early July (currently scheduled for 5 July).

To minimise the excavation and noise created by these works, our contractors Brian Perry Civil Ltd are using trenchless, cured-in-place pipe lining technology where possible.

The process of flushing the pipe, inserting the lining, curing it and then bringing the pipe back into service typically takes around eight hours, not including set up and packing down. This means we need to do these works overnight, to avoid lane closures on Aro Street during peak traffic times.

We have worked closely with Wellington City Council’s roading team to develop this plan and are awaiting final sign off of the traffic management plan, however wanted to provide you with as much notice as possible of the currently scheduled works. If there are any changes, we will communicate these directly with you.



Expected start date: Sunday 5 July

Working hours: Sunday to Thursday, 6pm to 5am

Location: 162 to 206 Aro Street, working from south to north. We are renewing the whole length of the pipe, but by using trenchless technology we can reduce the extent of lane closures and traffic management to five sections, as shown on the right.

Expected duration: Five weeks / 25 work nights

Once the pipe is re-lined, we will reline lateral connections to private property.



Noise and disturbance created by these works

There will be noise and vibration created by these works, including vehicles, generators and heavy equipment. To minimise the disturbance to residents, higher-noise activities such as concrete cutting will stop at 11pm each night.

Our contractors will use acoustic “blankets” or covers around machinery, and have noise monitoring in place to manage sound levels. For most of the time, the main source of noise will be the re-lining equipment, which produces a steady hum, at a volume which doesn’t typically require ear protection.



Traffic management

The relining work will be done in segments, working up the street from number 162. Each segment will require one lane of the road to be closed, with a stop-go system in place to allow vehicles to move safely past the work site.

Pedestrians and cyclists will also be directed around the site as needed.

No car parks should be affected, and bus stops will be temporarily moved a short distance to continue safely operating. Driveways will remain open and accessible for residents.



Why can’t these works be done during the day?

The process of cleaning and inspecting each section of pipe, fully inserting the liner and curing it into place takes approximately eight hours, not including set up and pack down. Given Aro Street is a major thoroughfare, daytime works are usually limited to between 9am and 4pm (seven hours) to avoid lane closures during peak traffic flows. This means there isn’t enough time to finish the job during the day, and pausing halfway through would result in pipe blockages and overflows.



Are there any other works planned in the area?

This is part of a package of wastewater renewals happening across Aro Valley. There are currently other pieces of work happening at Holloway Road and Landcross Street, and future portions will cover Fairlie Terrace, Adams Terrace and Maarama Crescent. We are also planning to upgrade one of the drinking water pipes on Aro Street, and we will provide more information on each of these projects in the next few weeks.

We appreciate this represents a significant disruption for local residents. We apologise for the inconvenience and appreciate the community’s patience and understanding while we complete this important mahi.

17 June 2026 Indicative schedule of works

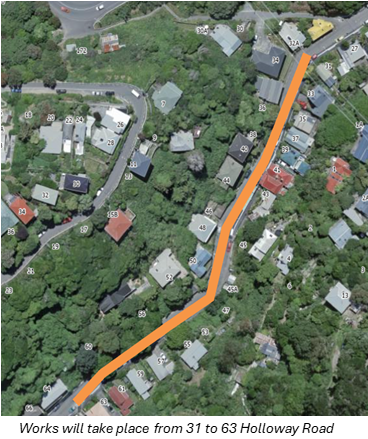

The works involve relining or replacing the wastewater pipe as indicated in orange on the map below. Arrows indicate access points where manholes need to be installed, and the yellow circles indicate existing manholes which need to be accessed and potentially upgraded or repaired depending on their condition.

The precise methodology and timing of this work may change due to the condition of the pipe, discovery of other underground services, or other unforeseen circumstances.

Week one, 15 to 18 June

During the first week, crews will begin constructing manholes to allow them to access the wastewater pipe outside 39, 47 and 55 Holloway Road. They'll be working between 7pm and 5am, Monday to Thursday, finishing at 5am Friday morning

7pm to 11pm

Asphalt cutting – A floor saw will be used to cut the road surface to allow access for the manhole works.

Plate compaction – A plate compactor will be used to compact material around the manholes.

Over-pumping (if required) – A 2-inch pump and generator may be used to temporarily bypass wastewater flows. Please note that these generators are not standard inverter types and may produce a noticeable humming noise.

Asphalt reinstatement – A plate compactor will be used to compact and seal the asphalt around the work area.

11pm to 5am

Air-Vac excavation – Vacuum excavation equipment will be used to safely expose underground services. As noise reduces with distance, it may be more noticeable for nearby properties. Where available, equipment designed for built-up residential areas will be used.

Backfilling – Reinstating excavated areas, which is generally a relatively quiet activity.

Weeks two and three, 21 June to 2 July

Working hours will change to 5pm to 5am, Sunday to Thursday, finishing at 5am on Friday morning. The noisiest work will continue to take place before 11pm. Due to having four working nights the previous week, construction of the final manhole may happen in weeks two or three.

Crews will install inspection points and reline the wastewater pipes.

Works will progress along Holloway Road at approximately three properties per night, starting from 31 Holloway Road.

5pm to 11pm

Asphalt cutting

Air-Vac excavation

11pm to 5am

Backfilling

Pipe lining and curing – Installation of the cured-in-place pipe (CIPP) liner is generally a quiet process; however, associated equipment, including the steam truck, compressor and flushing equipment, will generate a continuous humming noise. The steam curing process is expected to operate continuously for approximately three to four hours each night.

Week four, 5 to 9 July

Crews will be relining property laterals (the pipes which carry wastewater from private property to the public wastewater pipes). Working hours will remain from 5pm to 5am, Sunday to Thursday, finishing at 5am on Friday morning. The noisiest work will continue to take place before 11pm.

5pm to 11pm

Asphalt cutting

Air-Vac excavation

11pm to 5am

Backfilling

Lining and curing of the laterals, including the use of associated equipment that may generate a constant low-level humming noise during the curing process

12 June 2026 Works beginning 15 June on Holloway Road

The current pipe is over 100 years old and if it is not upgraded, there is a risk of breakage, collapse, or stormwater entering the pipe, which would lead to untreated wastewater and solid waste overflowing into the street, onto private property, and onto parks and reserve land. This presents a hazard to public health as well as the natural environment, which is why these works are taking place.



These works involve replacing and upgrading manholes between 31 and 63 Holloway Road, so the wastewater pipe can be re-lined using Cured-In-Place pipe lining, or CIPP. This involves inserting a flexible lining material into the existing pipe which is then cured with UV or steam, creating a strong impermeable barrier which extends the life of the pipe.



Works are currently planned to take place from 15 June to 15 July, with our contractors working at night to minimise the time required and the disruption to the community.
