Water Networks / Projects / Projects / Newtown Wastewater Improvements

Newtown wastewater improvements

We’re upgrading parts of the wastewater network in Newtown to protect our community and environment from exposure to untreated wastewater.
Overview
Background
Works schedule
All Updates

Parts of the wastewater network are more than 100 years old and are no longer operating effectively. Recent CCTV inspections highlighted sections which are in very poor condition.

Start Date
17/08/2026
End Date
31/07/2027
Contact:

If you have any questions about this work, please contact:

Tiaki Wai,  0800 TIAKI WAI (0800 842 549)

Latest Updates

27/10/26 Update on Owen St and related works

Good progress has also been made on the section of Owen Street from the Harper Street intersection to the Cardall Street intersection. This section of road will open again by Thursday 28 October.

02/10/26 Work is progressing well on the Owen St wastewater upgrade.

The main wastewater pipe that runs along Owen St, from Harper St to the Constable Rd intersection is being replaced, and the lateral pipes that branch off from the main pipe and connect to individual properties will also be replaced to the edge of property boundaries.

17/08/26 August 2026

The first section of work to begin is in Cardall Street, all going well, the work will be finished in October.

Newtown is one of Wellington’s oldest suburbs, dating back to the city’s early residential developments of the 1840s.  Parts of the wastewater network are more than 100 years old and are no longer operating effectively. Recent CCTV inspections highlighted sections which are in very poor condition.

Before July 2027, we’ll replace 3,100 metres of wastewater pipes and renew approximately 130 manholes and lamp holes (inspection points).

Due to the size and complexity of these works, the programme has been split into three separate portions.
Most of the pipe will be renewed using trenchless relining methods. However, trenching will be required in some areas.

Portion 1 involves renewing five sections of pipe along parts of the following streets:

  1. Owen Street
  2. Rintoul Street
  3. The intersection of Constable Street and Owen Street
  4. Harper Street
  5. Cardall Street


Expected construction dates – August 2026 to February 2027

Portion 1 construction areas


Portion 2 involves renewing sections of pipe along parts of the following streets:

  1. Russell Terrace
  2. Mansfield Street
  3. Wilson Street
  4. Mein Street
  5. Hospital Road

Expected construction dates – January to June 2027

Portion 3 involves renewing 18 sections of pipe along parts of the following streets:

  1. Blucher Avenue and Coromandel St
  2. Hall Avenue, Colombo Street and Riddiford Street
  3. Hospital Road and Riddiford Street
  4. Riddiford Street and Kerwyn Terrace
  5. Rintoul Street and Kerwyn Terrace
  6.  Emmett Street
  7. Wilson Street and Constable Street
  8. Constable Street and Owen Street
  9. Owen Street and Hiropi Street
  10. Harper Street and Cardall Street
  11. Coromandel Street and Colville Street
  12. Wingate Terrace and Daniell Street
  13. Antico Street
  14. Colombo Street
  15. Manley Terrace and Adelaide Road
  16. Melrose Crescent
  17. Riddiford Street
  18. Sutherland Crescent


Expected construction dates – February to June 2027

Street  Expected dates Work overview Work hours Expected impacts
Cardall Street   31 August –
29 October
Pipe renewal Lateral pipe lining 8am – 5pm Road access: Cardall Street remains open to residents.
Disruption: Noise and vibrations during the day.
Owen Street:
Harper Street intersection to Cardall Street intersection
7 October – 26 October Pipe Renewal
Lateral pipe lining
8am – 5pm Disruption: Noise and vibrations during the day.
A small generator will run overnight with sound blankets to soften sound.
Owen Street:
Cardall Street intersection to Constable Street intersection
26 October – 26 November Pipe renewal
Lateral pipe lining
8am – 5pm Disruption: Noise and vibrations during the day.
A small generator will run overnight with sound blankets to soften sound.
Harper Street 27 November – 21 December   Pipe renewal
Lateral pipe lining
8am – 5pm Some noise and vibration.
Parking will be limited in working areas, plus footpath diversions.
Rintoul Street
Between Millward Lane and Stoke Street
6 January –
23 February
Pipe renewal
Lateral pipe lining
To be confirmed To be confirmed
Rintoul Street
Outside Wellington Hospital
23 February –
4 March
Pipe grouting To be confirmed

To be confirmed

Road access map

Map showing road access from 27 October to 26 November

All Updates

27/10/26 Update on Owen St and related works

Some sections of the wastewater network in Newtown are more than 100 years old and in very poor condition. The work currently happening in your area to upgrade sections of the wastewater network is part of a wider programme of work happening across Newtown.

These upgrades will make your wastewater services network more reliable by fixing leaks, improve performance, and help protect the health of our community and environment.



Work planned

Our trusted contractor McMaster Civil Ltd has made good progress on these improvements in Cardall Street, and the remaining pipe work will be completed by Thursday 28 October.

Good progress has also been made on the section of Owen Street from the Harper Street intersection to the Cardall Street intersection. This section of road will open again by Thursday 28 October.

You may have noticed that Owen Street has no entry from the Constable Street intersection. This closure will continue until 26 November as indicated on the map.

You can see work expected in your area in the schedule.



02/10/26 Work is progressing well on the Owen St wastewater upgrade.

The main wastewater pipe that runs along Owen St, from Harper St to the Constable Rd intersection is being replaced, and the lateral pipes that branch off from the main pipe and connect to individual properties will also be replaced to the edge of property boundaries.

The work will be split into four stages, and we’re planning to have it completed by November 23.

Stage 1

22 September to 16 October 2026

Harper/Owen St the intersection to 91 Owen St (marked in red). The road will be closed between Harper and Regent St on 6 October 2026 only between 9am and 3pm.

Stage 2

7 October to 30 October 2026

Owen St to intersection of Cardall/ Owen St (marked in blue)

Stage 3

21 October to 13 November 2026

From the intersection of Cardall/ Owen St to numbers 79 and 77 Owen St (marked in green)

Stage 4

5 November to 23 November 2026

From outside number 77 and 79 Owen St to the Constable St intersection (marked in orange).



The section of Owen St highlighted in the map above will be closed to through traffic at all times from 22 September to 19 October. In stages 3 and 4, Owen St will be closed during the day only and one lane will be open to traffic outside working hours. Residents will be able to access their properties at all times. Crews will be onsite from 7am to 6pm, Monday to Friday.

To help keep everyone safe and minimise disruption, traffic management will be in place around the work site.

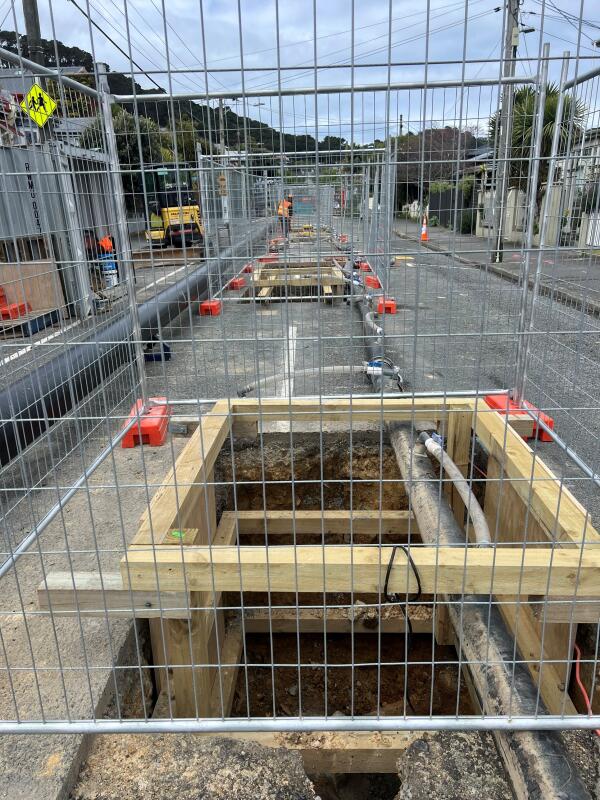

Square holes reinforced with wood and surrounded by silver fences with pipes running along the road on Owen St, Newtown.

17/08/26 August 2026

The first section of work to begin is in Cardall Street.  The main stages of work involve:

  1. CCTVing pipes.
  2. Installing inspection points.
  3. Renewing wastewater pipe.
  4. Replacing two manholes.
  5. Relining laterals (connecting pipe to properties).
  6. Reinstating the road and footpath.


Traffic management will be in place to keep everyone safe and guide traffic around the work site.  One lane of the street will be closed, and parking will be restricted near the worksite.

All going well, the work on Cardall Street will be finished in October.

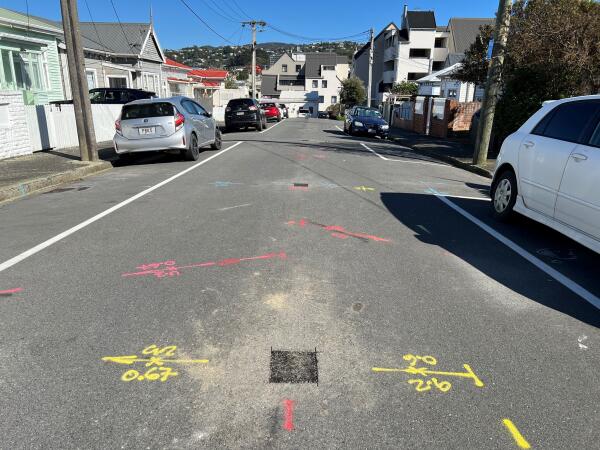

Cardall St, Newtown marked up with spray paint where pipes and other services are for wastewater works August 2026
